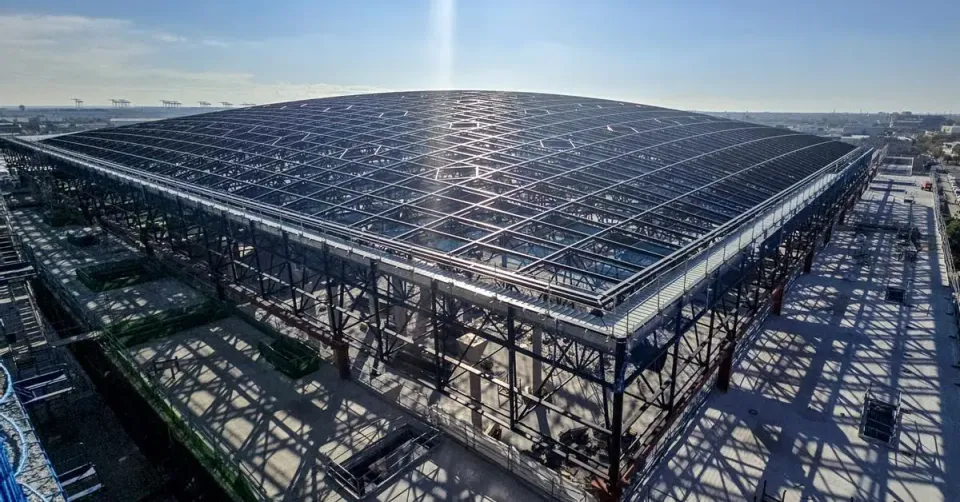

Fira de Barcelona expansion is reaching a crucial milestone as the enormous dome of its new Hall Zero pavilion nears completion.

According to reports from Ara, the steel structure, comprising around 9,000 interlocking pieces, is being assembled at the Gran Via site in L’Hospitalet de Llobregat.

Your browser does not support the video tag.

The project, which broke ground in late 2023, is now 45% complete and promises to transform the city’s capacity for major international events.

Fira de Barcelona Expansion Creates Column-Free Arena

The defining feature of the new Hall Zero will be its vast, column-free interior. Consequently, the main exhibition space will measure 120 by 135 metres, a floor area equivalent to ten Olympic swimming pools. Furthermore, with a 20-metre ceiling height, the hall is designed for versatility. Albert Civit, managing director of Fira 2000, notes it could fit the entire Palau Sant Jordi inside. This flexibility will allow the venue to host not just trade fairs, but also major concerts and sporting competitions.

Construction is set to accelerate significantly in the new year. Once the dome is fully installed, the workforce will expand from over 100 to around 600 operatives. Their focus will shift to completing the interior structure, façades, and essential utilities. The overall project will add over 60,000 square metres of exhibition space, increasing the Gran Via complex’s total area to 300,000 square metres.

Project Timeline and Economic Impact

The total budget for the Fira de Barcelona expansion stands at €365 million, a figure higher than initially planned. This increase accounts for additional square footage and higher land acquisition costs. The core construction work itself accounts for €250 million of the total. Meanwhile, the project includes a 12-storey office tower, seven floors of which are already built, destined for the Generalitat and Fira de Barcelona, with potential for third-party rental.

Architecturally, the pavilion will feature a striking Gaudí-esque lobby designed by Japanese architect Toyo Ito, in collaboration with the Barcelona firm b720 Fermín Vázquez. Additionally, the first floor will house coveted ‘executive meeting rooms’ for high-level deal-making, connected to the existing pavilions via a bridge over Avinguda Joan Carles I.

Despite the rapid progress, the venue’s full opening is scheduled for mid-2027. Therefore, flagship events like the Mobile World Congress will have to wait until 2028 to utilise the new space. In the interim, Fira 2000 is making other improvements, including a €6 million refurbishment of the convention centre in the existing Pavilion 2, set to be ready for next year’s events. This upgrade, which includes a new 500-seat auditorium, will also benefit other major shows like the Integrated Systems Europe (ISE) fair.

The Fira de Barcelona expansion is a cornerstone of the city’s strategy to bolster its congress and events sector. This development arrives alongside other significant urban projects, such as the groundbreaking of the new €82 million state library. Moreover, it reflects a broader regional focus on strategic investment, similar in scale to the €120 million sports infrastructure overhaul recently launched in Catalonia. Ultimately, the completion of Hall Zero will solidify Barcelona’s position as a premier global destination for business and culture.
